WinForms Gantt — Visualize Project Schedules within a Timeline
Our WinForms Gantt Control ships with a new timeline UI element (v23.1). The Gantt control itself allows you to plan/manage projects, while the timeline displays start and due dates for individual tasks and offers a bird's eye view of project progress.

Timeline UI
The timeline can display multiple timeline bars with tasks/milestones, a today indicator, and date range selector.

The timeline's context menu allows users to add/remove timeline bars, remove tasks/milestones from the timeline, or quickly navigate to a task within the Gantt tree and chart.

Display Timeline
The Gantt control can display a timeline at the top or bottom.

using DevExpress.XtraGantt;
// Displays a timeline at the top of the Gantt control.
ganttControl1.OptionsTimeline.TimelinePosition = TimelinePosition.Top;
User Experience
End user options include:
- Add/Remove Tasks and Milestones to/from Timeline
- Add/Remove Timeline Bars
- Select Multiple Tasks (click on a task and hold down the Ctrl key to select the task)
- Go to Task
- Pan and Zoom Timeline Scale
- Select Time Range
- Resize Timeline
Timeline Customization Settings (API)
Use the GanttControl.OptionsTimeline
property to access and customize the following timeline settings:
TimelinePosition
— Specifies the visibility and position of a timeline.AllowResize
— Specifies whether the height of a timeline can be modified by a user or in code.TimelineHeight
— Specifies timeline height (in pixels).ShowTodayIndicator
— Specifies whether to display the Today indicator.MinUnit/MaxUnit
— Specify minimum/maximum time intervals.
You can modify the caption/details/description of individual tasks based on a specific condition. To apply modifications, handle the CustomTimelineItemText
event. The Gantt control fires this event for each task displayed within the timeline.
We also implemented Custom Draw APIs so you can paint timeline bars and tasks as needed. These APIs include:
CustomDrawTimelineBar
CustomDrawTimelineTask
Bind the Timeline to Data
Use the following properties to map fields in your data source to task properties:
ChartMappings.TimelineCaption
— Specifies the name of a field in a data source (with string values used for task captions on the timeline).ChartMappings.VisibleInTimelineFieldName
— Specifies the name of a field in a data source (with Boolean values that specify which tasks to display on the timeline).
public Form1() {
InitializeComponent();
// Bind the Gantt control to a data source.
ganttControl1.DataSource = TaskData.InitData();
// Configures the Gantt control's mappings.
ganttControl1.TreeListMappings.KeyFieldName = "Id";
ganttControl1.TreeListMappings.ParentFieldName = "ParentId";
ganttControl1.ChartMappings.StartDateFieldName = "StartDate";
ganttControl1.ChartMappings.FinishDateFieldName = "EndDate";
ganttControl1.ChartMappings.TimelineCaption = "TimelineCaption";
// Maps the Gantt control to a field in a data source with Boolean values that
// specify which tasks to display on the timeline when the application starts.
ganttControl1.ChartMappings.VisibleInTimelineFieldName = "ShowInTimeline";
}
public class TaskData {
public TaskData(int id) {
this.id = id;
}
int id;
public int Id {
get { return id; }
}
public string TimelineCaption {
get { return string.Format("Timeline Caption: {0}", Name); }
}
public bool ShowInTimeline { get; set; } = false;
public int ParentId { get; set; }
public string Name { get; set; }
public DateTime StartDate { get; set; }
public DateTime EndDate { get; set; }
public static List<TaskData> InitData() {
return new List<TaskData>() {
new TaskData(0){ Name = "Task A", ParentId = 0, StartDate = new DateTime(2023, 3, 1), EndDate = new DateTime(2024, 3, 31) },
new TaskData(1){ Name = "Task B", ParentId = 0, StartDate = new DateTime(2023, 3, 1), EndDate = new DateTime(2023, 7, 1), ShowInTimeline = true },
new TaskData(2){ Name = "Task C", ParentId = 0, StartDate = new DateTime(2023, 7, 1), EndDate = new DateTime(2023, 11, 1) },
new TaskData(3){ Name = "Task D", ParentId = 0, StartDate = new DateTime(2023, 11, 1), EndDate = new DateTime(2024, 3, 31) },
};
}
}

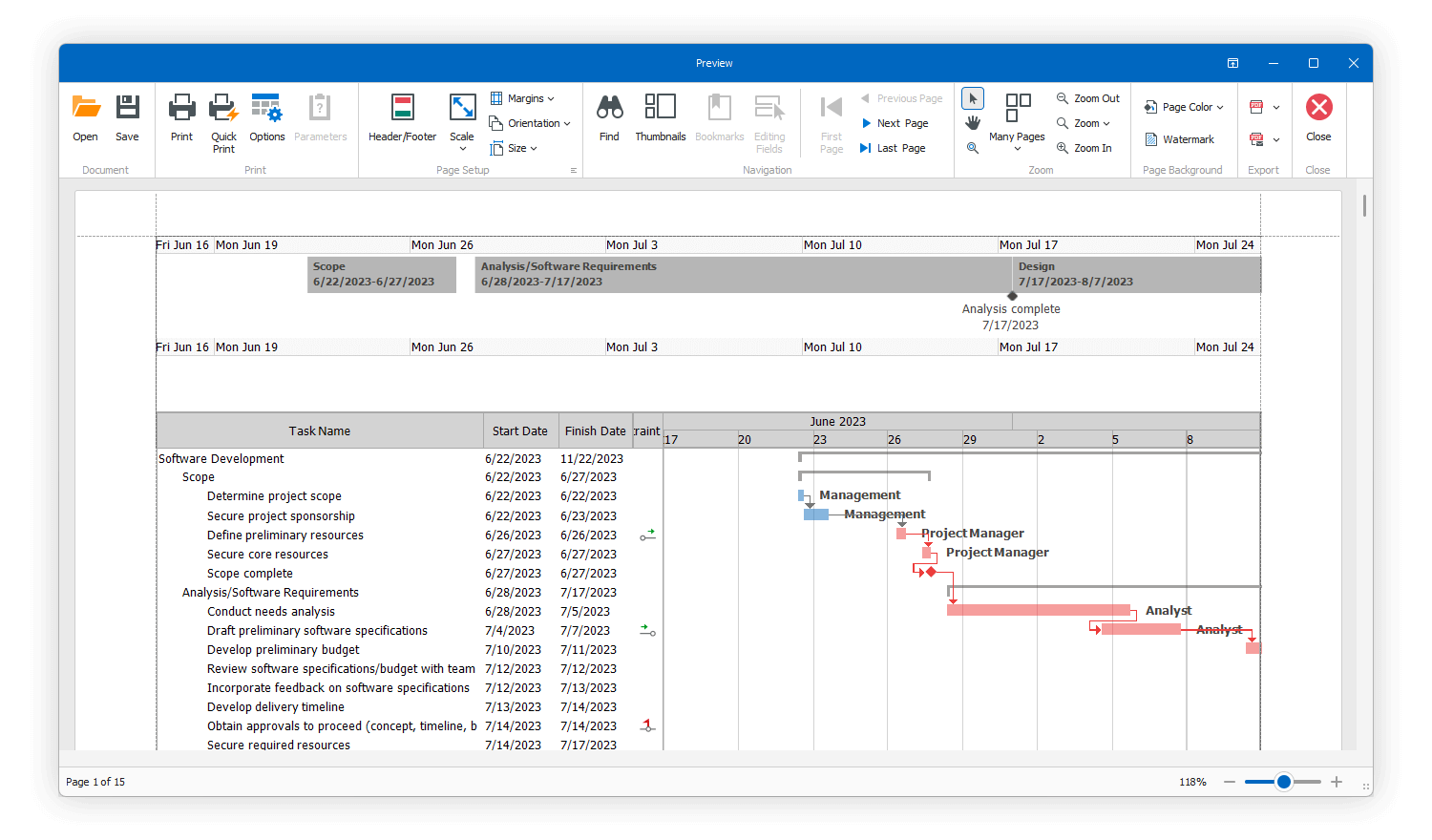

WYSIWYG Printing and Export
You can print/export the Gantt and its timeline. Supported export file formats include: PDF, XLS, XLSX, MHT, CSV, HTML, RTF, DOCX, TXT (or as an Image file).
